Crews digging deep for X2 Condos foundation

Facebooktwitterredditpinterestlinkedinmail



But as the middle of February approaches, the excavation crews continue to dig deeper, and it’s clear that I’ll have to wait awhile longer before I’ll get to watch the crane installation.

A project of Great Gulf Homes and Lifetime Developments, and designed by Toronto’s Wallman Architects, X2 Condos will contain 470 suites in a 49-storey tower rising directly across Charles Street from  X Condos, its 44-floor “sister” skyscraper which was completed and occupied in 2010.

Below are renderings of the X2 Condos building, along with a series of photos I have shot showing the project site both before and during excavation.



X2 Condos Toronto

This artistic rendering of the X2 Condos complex appears on a billboard mounted on hoarding around the construction site



X2 condos Toronto

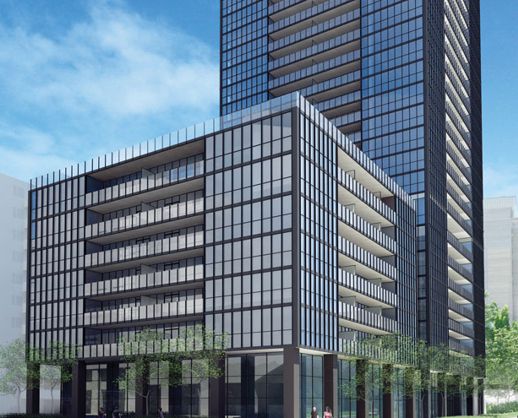

This rendering of X2 Condos appears on the Lifetime Developments website



X2 Condos

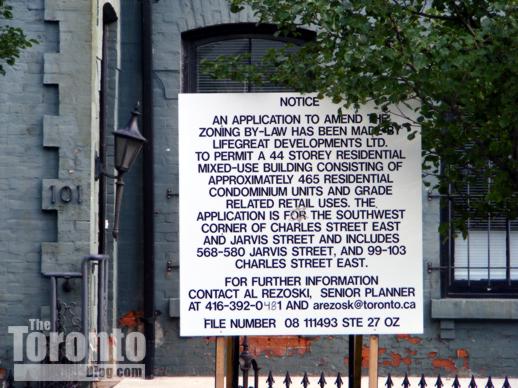

August 14 2008: A development proposal sign posted outside 101 Charles Street East — part of the future X2 Condos site. Developers originally planned a 44-storey tower, but later obtained city approval to add 5 more floors



101 Charles Street East Toronto

August 6 2008: 101-103 Charles Street East, one of two brick houses converted into offices that formerly occupied the X2 Condos site



103 Charles Street East Toronto

A Google Street View image of 97-99 Charles Street East, the second house that once occupied the X2 Condos site. Formerly office space for lawyers, the building’s final occupant was the sales centre for X2’s sister, X Condos



Former Pizza Pizza head office at 560-580 Jarvis Street Toronto

September 3 2008: The Pizza Pizza head office at 560-580 Jarvis Street formerly occupied the eastern flank of the X2 Condos site. During the 1980s and 90s, the building housed a Becker’s convenience store and a sports bar called Caps.



568-580 Jarvis Street Toronto

September 3 2008: The Pizza Pizza headquarters on the X2 Condos site, viewed from the intersection of Mount Pleasant Road and Jarvis Street



Charles Street East at Jarvis Street Toronto

This cobblestone-paved, tree-shaded terrace extended along Charles Street the full length of the Pizza Pizza building. Some of the trees have been left intact; others have been destroyed for X2’s construction



X2 Condos site

November 2 2009: Signage has been removed from the former Pizza Pizza headquarters as building demolition commences



X2 Condos Toronto

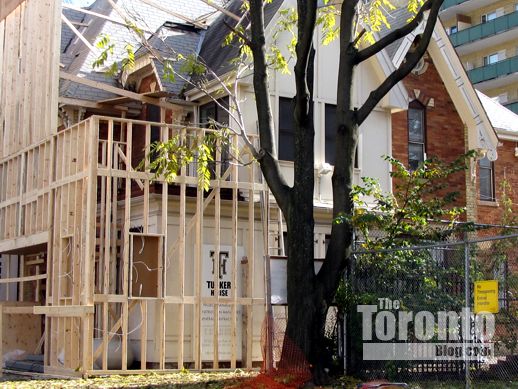

November 2 2009: Construction of the X2 Condos sales centre gets underway at 97-99 Charles East. Signs will be mounted on the wood frame.



X2 Condos billboard

November 22 2009: Signage advertising X2 Condos covers the facade of the former Pizza Pizza headquarters at the corner of Jarvis & Charles Streets



101 and 99 Charles Street East Toronto

November 22 2009: A bold 3-storey pink & white sign marks the location of the X2 Condos sales centre at 99 Charles Street East



X2 Condos site

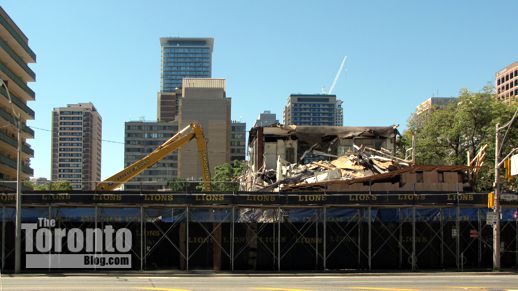

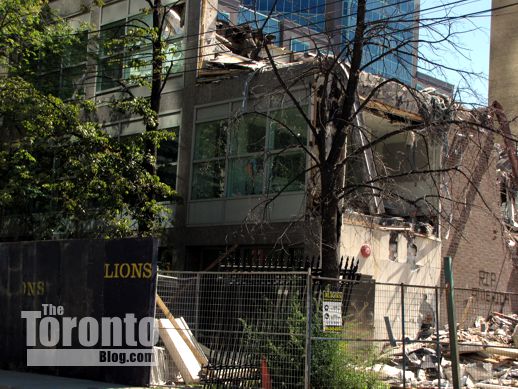

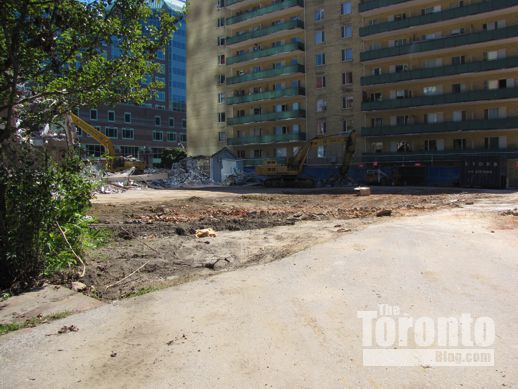

August 29 2010: Demolition of the former Pizza Pizza headquarters is underway



X2 Condos site

August 29 2010: Charles Street view of the Pizza Pizza building demolition



X2 Condos site

August 29 2010: An empty space and some broken bricks is all that remains of the house that previously stood at 101-103 Charles Street East



X2 Condos

August 29 2010: Looking east along Charles toward Jarvis Street. The one-time X2 sales centre at  99 Charles East has been partially demolished. The large building in the background on Jarvis is the Rogers Communications head office



X2 condos Toronto

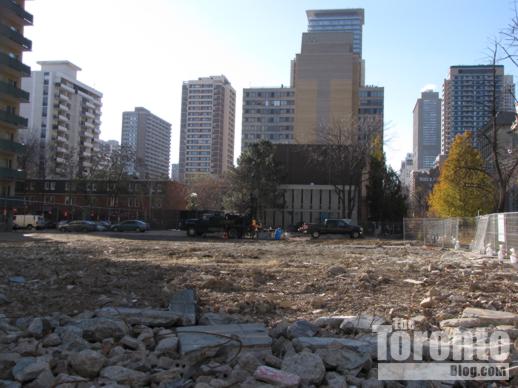

October 3 2010: Demolition of the three buildings is complete, and an empty lot remains where X2 will be built. That’s X Condos at the right.



X2 Condos

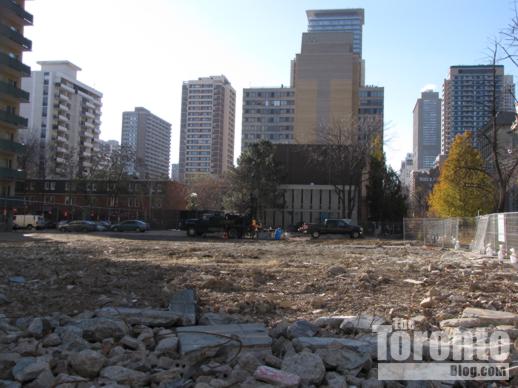

November 11 2010: Looking west from Jarvis Street across the X2 Condos site. At the far end of the property, a work crew is conducting soil tests.



X2 Condos

January 9 2011: Looking east across the X2 Condos site towards the Rogers Communications head office on Jarvis Street



X2 condos

January 29 2011: A view of the X2 Condos site from the east side of Jarvis Street



X2 Condos

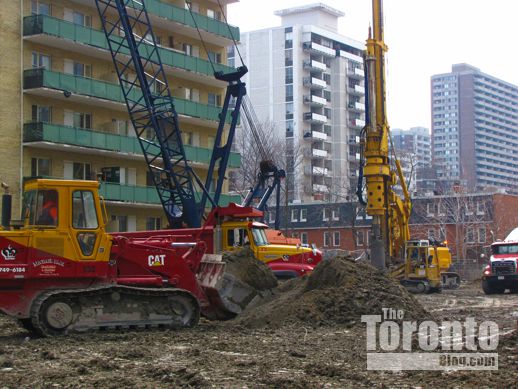

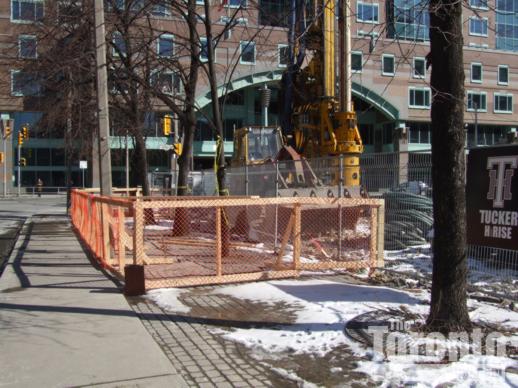

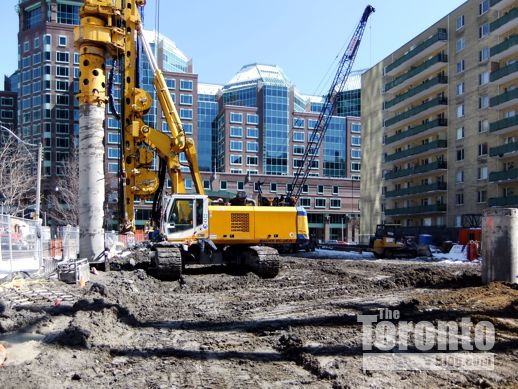

February 8 2011: A drilling machine and an excavator at work near the northwest corner of the X2 Condos site



X2 Condos site excavation

February 8 2011: They’ve got a long way to go — the machines will have to excavate a hole deep enough to hold six underground parking levels



 X2 Condos

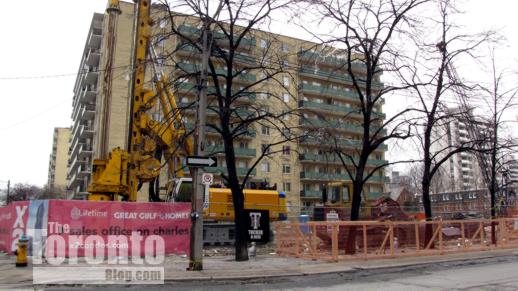

February 16 2011: A drilling machine works at the northwest corner of the X2 Condos site next to the intersection of Jarvis & Charles Streets



X2 Condos

February 23 2011: The City of Toronto has established protection zones for some of the trees alongside the X2 site on Charles Street



X2 Condo building site

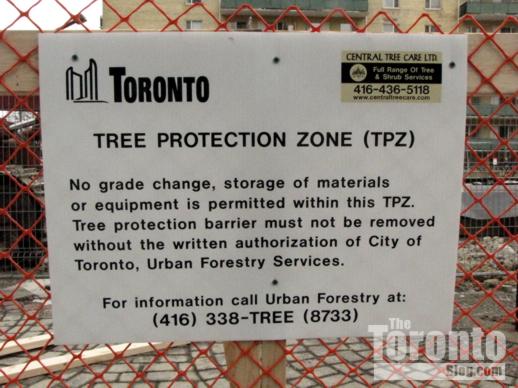

February 16 2011: A city sign on the tree protection enclosure



X2 Condos

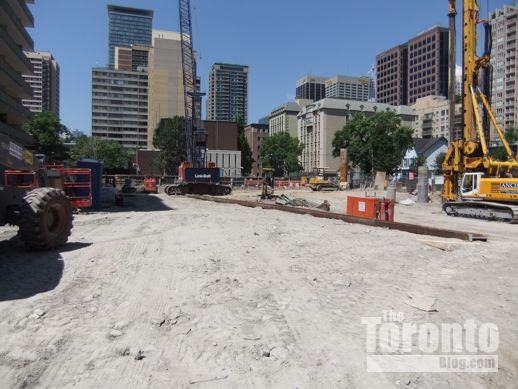

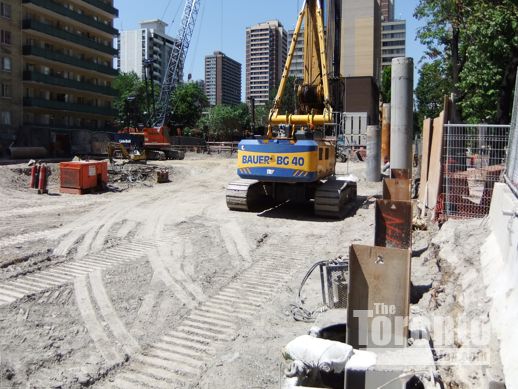

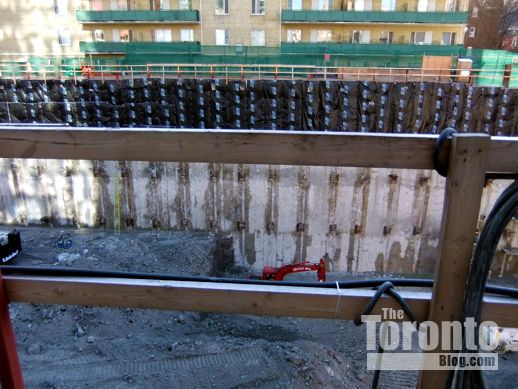

March 24 2011: Drilling and shoring machines on the X2 Condos site



X2 Condos

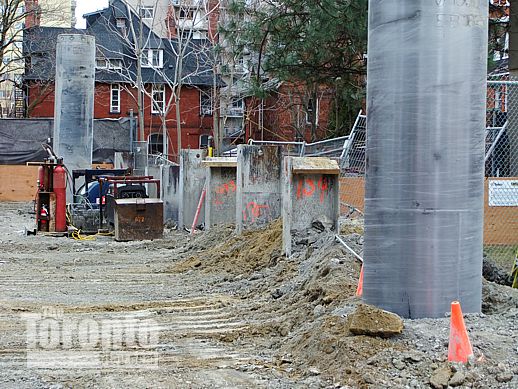

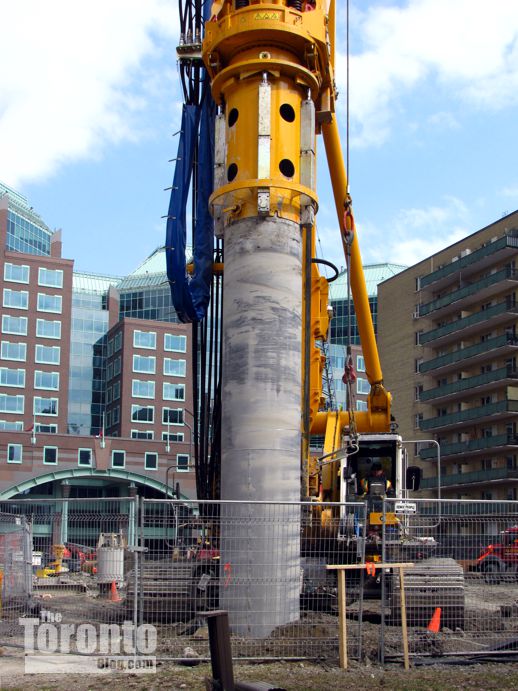

April 2 2011: Some of the steel I-beams sunk deep into the ground to shore up the west end of the construction site



X2 Condos

April 7 2011: A busy day of drilling and earth moving



X2 Condos

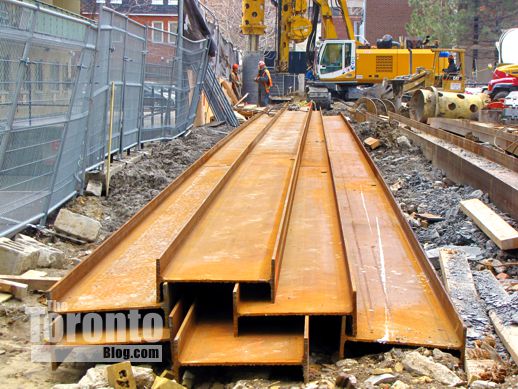

April 7 2011: A stack of the steel beams used to shore the site prior to excavation



X2 Condos

April 7 2011: Shoring activity at the northwest corner of the property



X2 Condos

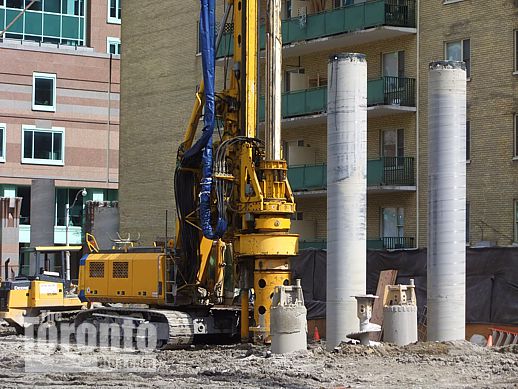

April 22 2011: Shoring work along the south side of the site, next to the 11-storey apartment building at 550 Jarvis Street



X2 Condos

April 22 2011: A tree protection zone next to the west end of the site



X2 Condos

June 5 2011: Drilling and shoring work continues into June



X2 Condos

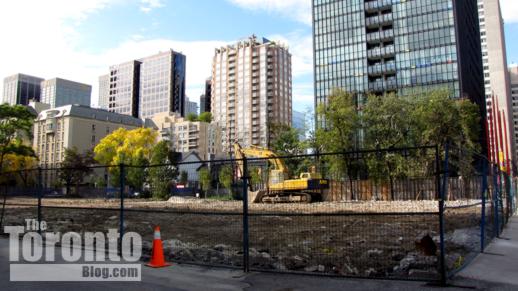

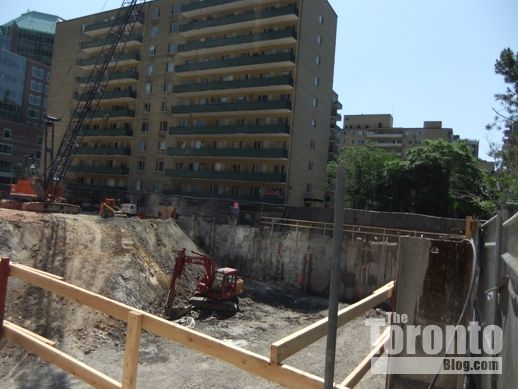

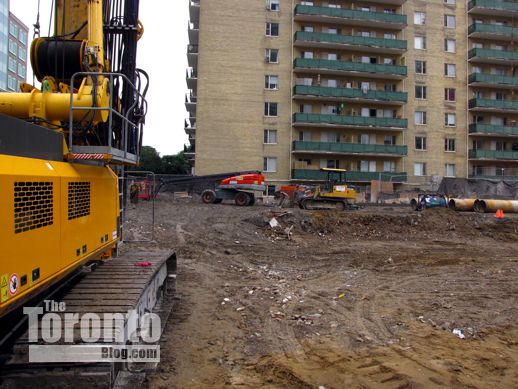

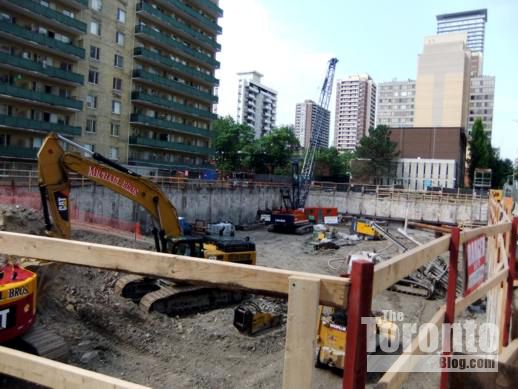

June 22 2011: Early stages of excavation on the east side of the site



X2 Condos

July 9 2011: From Jarvis Street, it appears that excavation hasn’t yet begun …



X2 Condos

… and that’s also the case looking across the site from the northeast corner …



X2 Condos

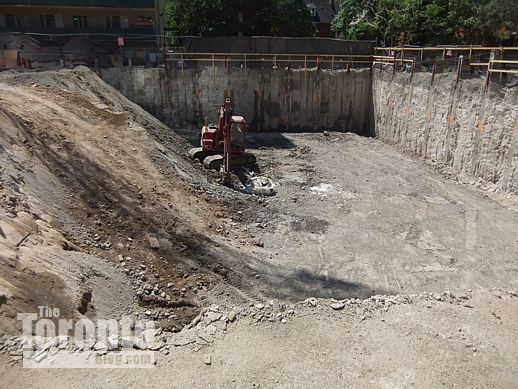

… but it’s an entirely different story at the west end of the property, where crews are quickly making progress with the excavation



X2 Condos

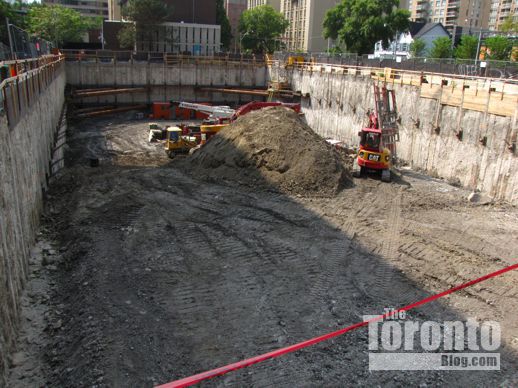

July 9 2011: Another view of excavation progress at the west end of the site



X2 Condos

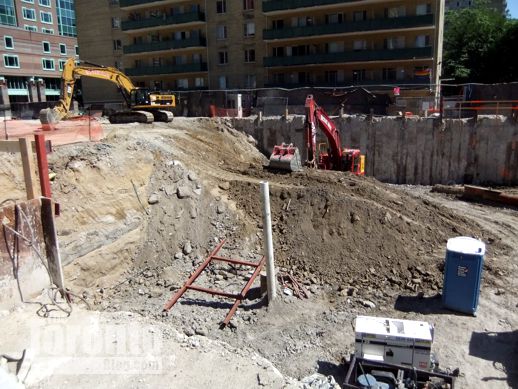

 July 16 2011: Looking across the excavation toward Jarvis Street through a security fence at the northwest corner of the X2 Condos site



X2 Condos

July 16 2011: Excavation progress near the middle of the property



X2 Condos

August 6 2011: Overlooking the excavation from the northeast corner



X2 Condos

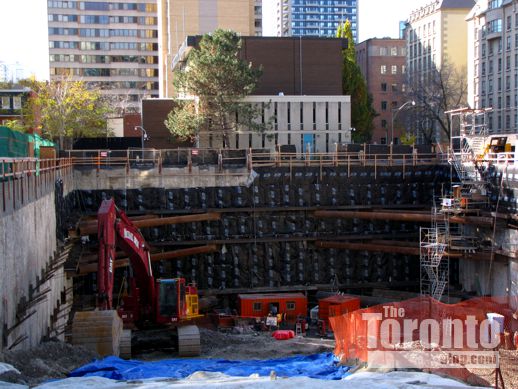

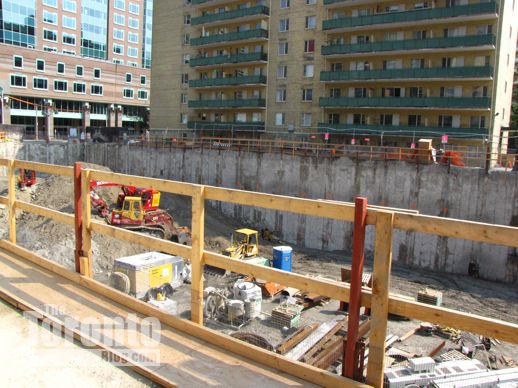

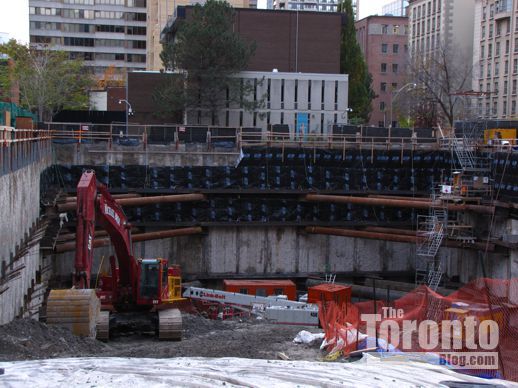

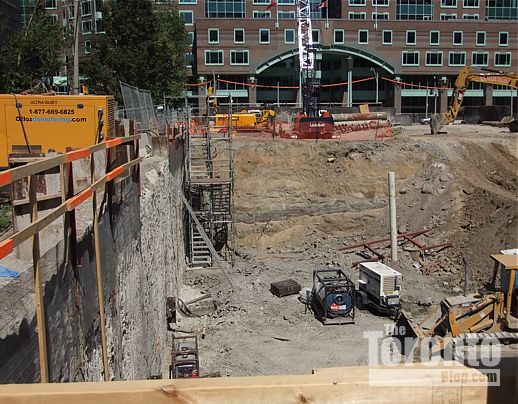

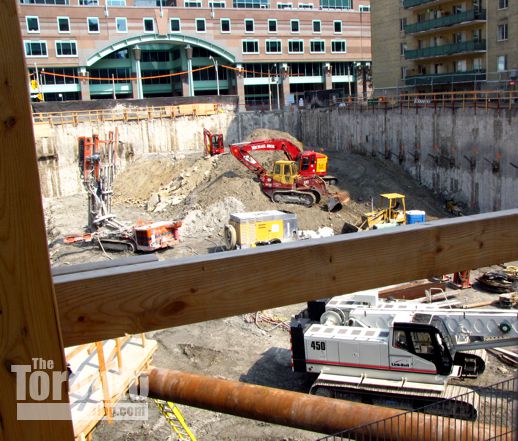

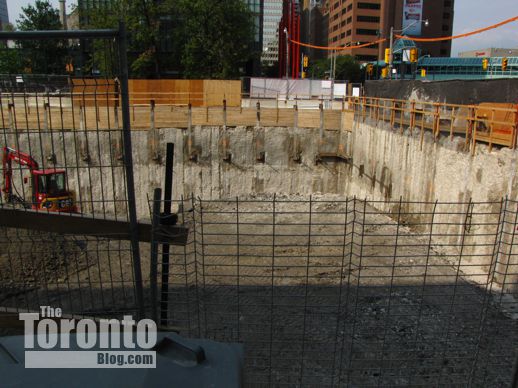

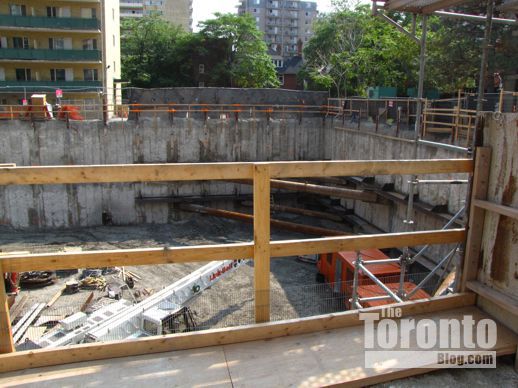

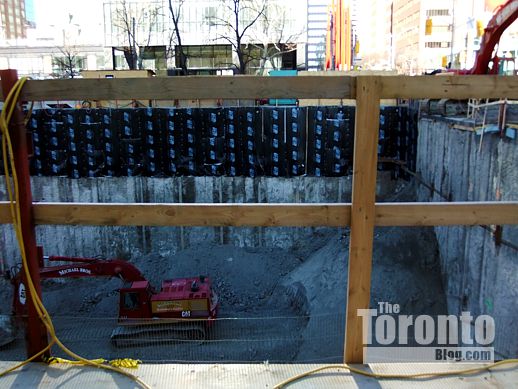

September 3 2011: The excavation is getting deeper across the entire site, viewed here from the southeast corner of the property near Jarvis Street



X2 Condos

September 3 2011: Excavation progress near the corner of Jarvis & Charles Streets



X2 Condos

September 3 2011: Overlooking the excavation from the west end of the site



X2 Condos

September 3 2011: Looking into the pit from Charles Street



X2 Condos

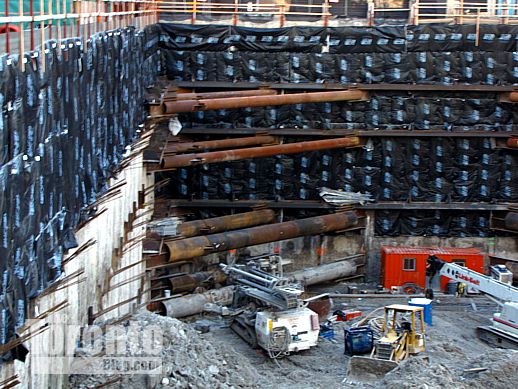

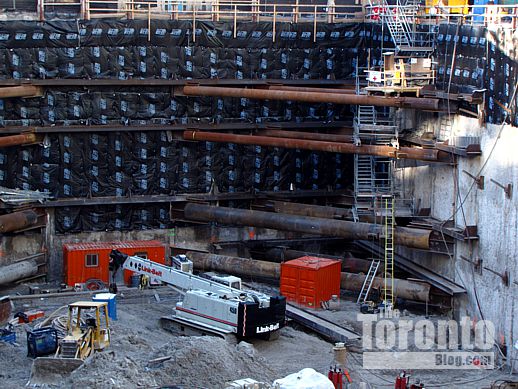

September 3 2011: Support pipes reinforce the southwest corner



X2 Condos

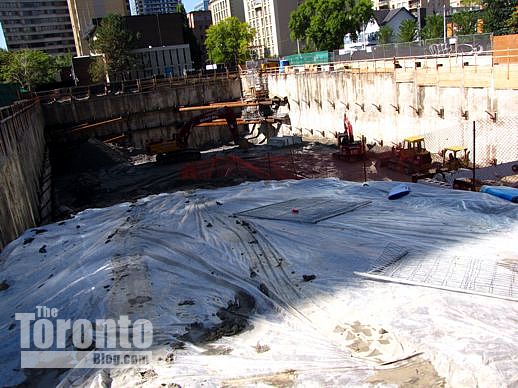

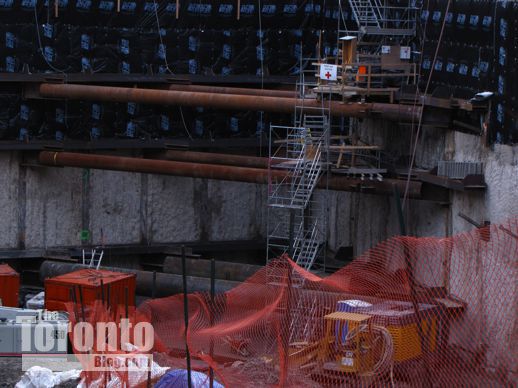

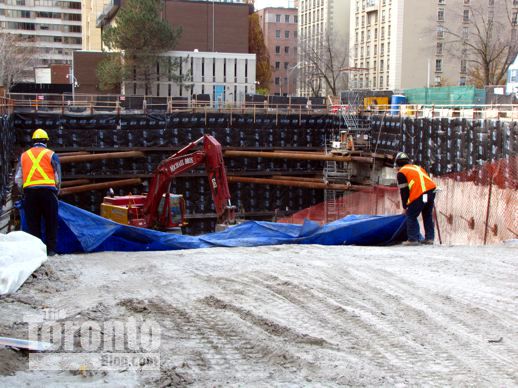

September 24 2011: Looking into the pit from the construction ramp off Jarvis Street. Protective tarps are pulled over the dirt ramp after crews finish work.



X2 Condos

October 29 2011: Excavation activity is focussed on the west end of the site



X2 Condos

October 29 2011: Construction workers access the excavation from the stairs at the northwest corner of the site



X2 condos

November 4 2011: Excavation keeps getting deeper at the west end



X2 Condos

November 19 2011: Workers pull tarps over the construction ramp



X2 Condos

 November 25 2011: Overlooking the dig from the southeast corner at Jarvis Street



X2 Condo

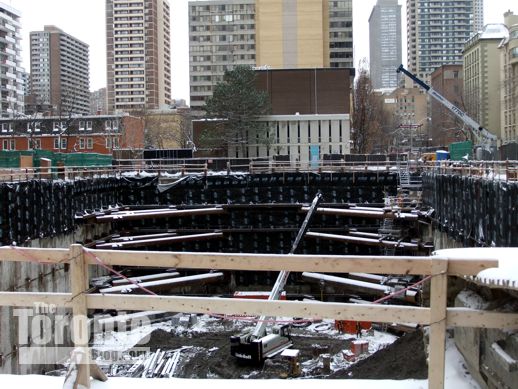

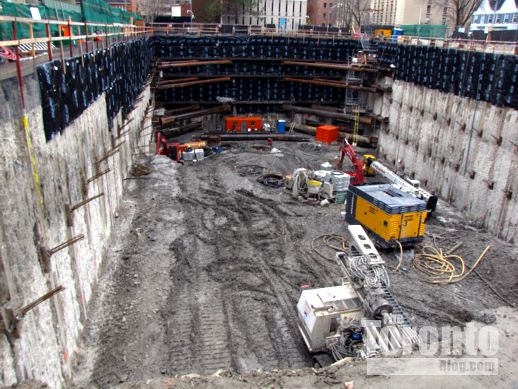

December 5 2011: Excavation work continues into the final month of the year



X2 Condos

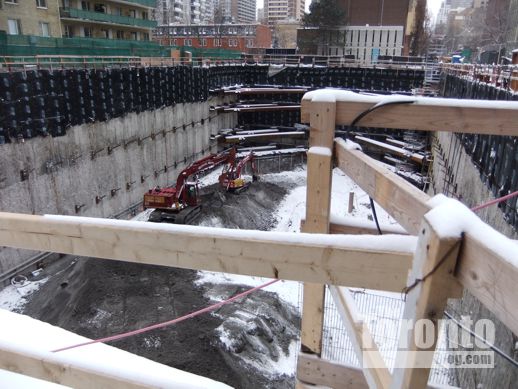

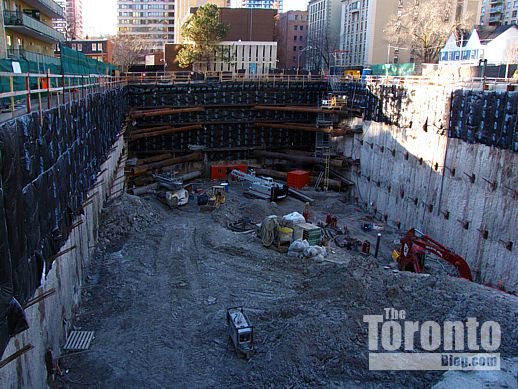

December 11 2011: Crews continue digging even deeper



X2 Condos

December 11 2011: A view of the northwest corner of the pit …



X2 Condos

… and a closer look at the southwest corner of the excavation



X2 Condos

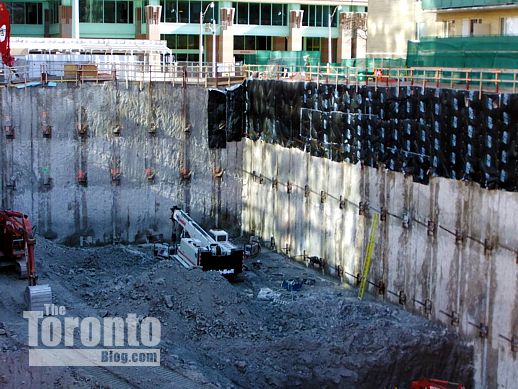

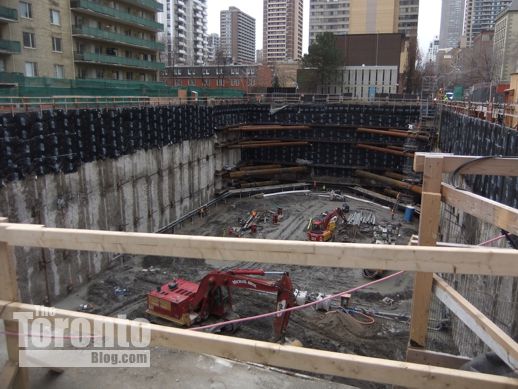

January 8 2012: There’s much more digging to be done in the southeast corner …



X2 Condos

January 8 2012 … and in the northeast corner, where a machine in the pit piles earth into a mound so an excavator at ground level can in turn scoop it into dump trucks waiting in a staging area on Jarvis Street



X2 Condos

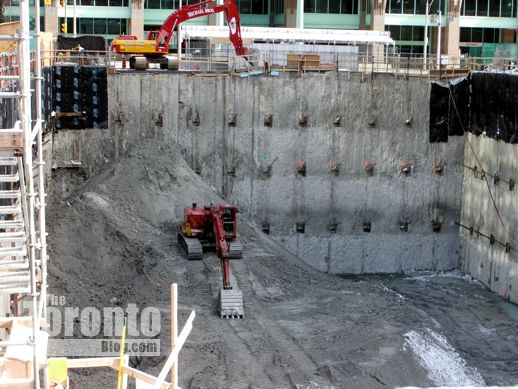

January 8 2012: A red excavator digs deep along the south side of the site



X2 Condos

January 13 2012: Work continues after a light snowfall blankets the site



X2 Condos

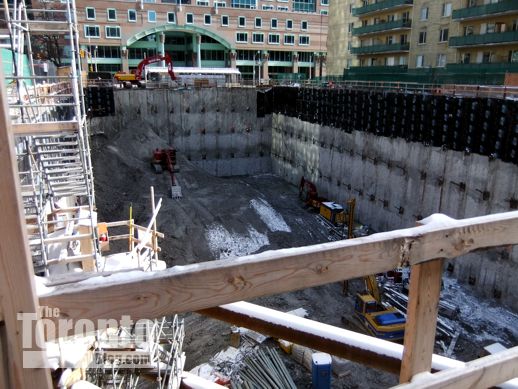

January 15 2012: There’s still a lot of earth to be moved from the northeast corner of the excavation …



X2 Condos

January 15 2012 … where the digger in the pit keeps feeding the one a few storeys above it on Jarvis Street



X2 Condos

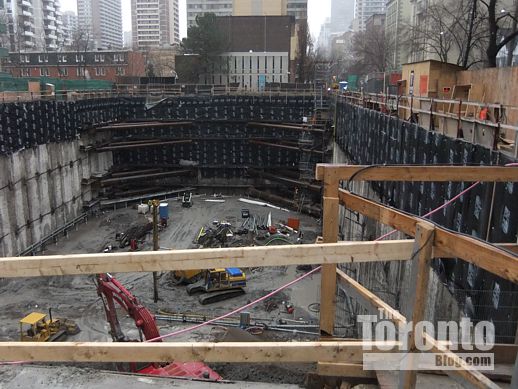

January 28 2012: As the month draws to a close, it looks like the excavation is complete, but there’s a lot more digging still to be done



X2 Condos

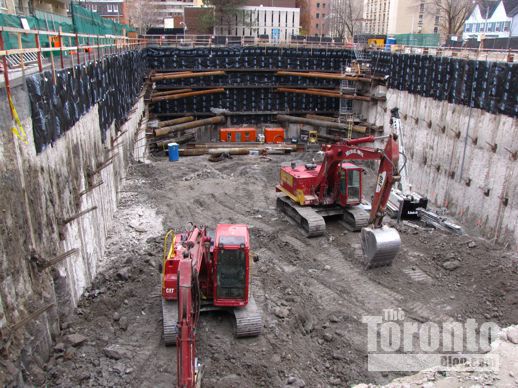

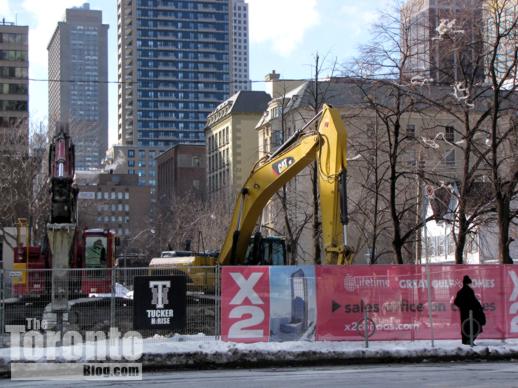

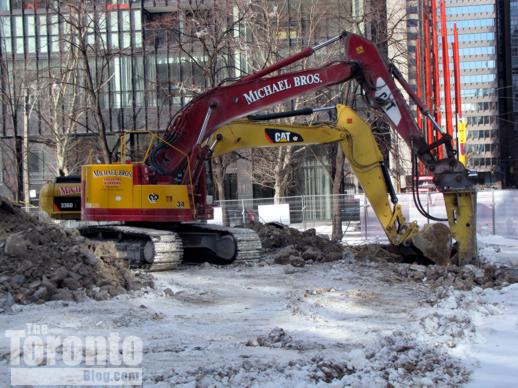

February 2 2012: The digging activity continues into another month



X2 Condos

February 9 2012: More earth moving at the west end of the excavation …



X2 Condos

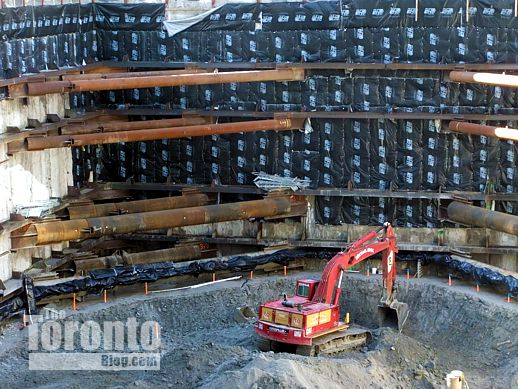

February 11 2012 … while yesterday two machines kept digging away
